CHS Renovation

Transparency is at the heart of the CHS renovation project. This page provides real-time updates on our progress and a clear breakdown of project expenditures, ensuring our neighbors stay informed on how we are delivering on our commitment to a revitalized campus.

Students cutting a ribbon at the newly renovated CHS

Project Updates

February 13, 2026 Update

With an end to our long period of ice and snow this week, exterior work has resumed. Interior work is picking up, and we are pleased to report great progress.

  • The roofing contractor, back on the project, started snow and ice removal of the old loading dock area and the band and choir area.

  • Old roofing material removal started on Wednesday, with new insulation

  • and roof membrane being installed, and the loading dock being

    completed.

● (See attached aerial photos)

Interior progress on art classrooms, labs, the last foreign language classroom, and the drafting lab is progressing forward. The two weeks of bad weather have allowed contractors to accomplish a great deal of work with no students or staff in the building.

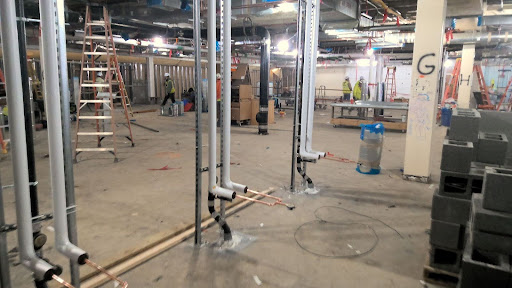

  • The plumbing contractor has 99% of the new overhead storm drains installed in this area.

  • The mechanical contractor has installed new ductwork and vav boxes for

    this area.

  • Electrical contractor installing overhead feeder conduits from the new

    electrical room. In-wall rough-in installation of new classrooms in existing

    cmu walls is in progress.

  • Plumbers are installing the heating water supply to vav boxes for each

    classroom.

  • Block layers are working on the last foreign language classroom, drafting

    classroom, and main exterior wall to the hallway and setting metal door

    frames, moving forward with cmu block walls for this area.

  • Insulation contractor wrapping ductwork that has passed inspection.

  • Plumbing contractor working on in wall rough-in for art classroom sinks.

Another shift was added for work in shops, Robotics, Auto 1 & 2, Building Trades, Precision Machining, and Welding.

  • Sheet metal contractor hanging new spiral duct supports.

  • Electrical contractor installing new electrical panel boards and

    conduit runs.
